1–3 Days on Roof, 2–8 Weeks: Roof Replacement Timeline for Kent

August 30, 2026
1–3 Days on Roof, 2–8 Weeks: Roof Replacement Timeline for Kent

A standard roof replacement usually needs just 1 to 3 days of on-site work, but the full project commonly spans 2 to 8 weeks from inspection to final sign-off. Permits, material lead times, and contractor backlogs stretch the calendar far more than the actual installation. Confirming material availability and agreeing on scheduling buffers upfront is the single fastest way to shave weeks off your wait.


TL;DR:

  • Permits, material lead times, and crew availability often determine the actual duration of a roof replacement, not the on-site installation days.
  • Material lead times vary significantly, from a few days for asphalt shingles to several weeks for tile or slate, heavily impacting scheduling.
  • Weather, roof complexity, and hidden damage are the main factors that can cause delays beyond initial estimates, with disruptions often occurring before installation begins.
  • Confirming material delivery in writing and scheduling during off-peak months can help shorten the overall timeline and prevent unexpected delays.
  • A typical roof replacement takes about four weeks from start to finish, with most delays coming from early project phases rather than the installation itself.

Table of Contents

The Roof Replacement Timeline, Phase by Phase

Most homeowners picture roof replacement as one continuous job. It's not. It's a series of phases, and several of them overlap without you ever noticing.

Here's the realistic breakdown from first phone call to final walkthrough:

  • Inspection and estimate: 1 to 3 days for a contractor to assess the roof and send a written quote
  • Contract and permits: 0 to 4 weeks, depending on whether your local authority requires approval for the work
  • Materials ordering: anywhere from a few days for in-stock asphalt to several weeks for specialty tile or slate
  • Crew scheduling: 1 to 6+ weeks, longer in peak spring and autumn seasons
  • On-site installation: 1 to 5 days depending on roof size and complexity
  • Final inspection and cleanup: 1 to 3 days

Here's the part that surprises most homeowners: permit approval, material ordering, and crew scheduling often run in parallel rather than one after another. A timeline calculator built around this logic treats your pre-install wait as the longest of those three tracks, not the sum of them. If your permit takes two weeks but your crew is booked for five, you're waiting five weeks, not seven.

Calendar days and working days aren't the same thing either. A "2-week" quote assumes no rain delays, no missed deliveries, and no surprises under the old shingles. Build in a buffer, especially if your quote lands in a wet month.

What Each Stage Actually Involves

Knowing the ranges is useful. Knowing what causes a quote to slip is what actually protects your schedule.

Inspection and quote. A contractor checks the deck, flashing, ventilation, and existing layers, then usually turns around a written estimate within a few days. Rushed inspections that skip the attic are a red flag; hidden rot doesn't show up from the ground.

Permits and approvals. Requirements vary by local authority. A straightforward like-for-like re-roof often needs no permit at all, while structural changes or conservation area properties typically do. Always confirm directly with your contractor rather than assuming.

Material lead times. This is where quotes quietly balloon. Standard asphalt shingles often ship in 1 to 3 days if in stock, while metal can take 1 to 3 weeks and tile or slate 2 to 6 weeks depending on the supplier.

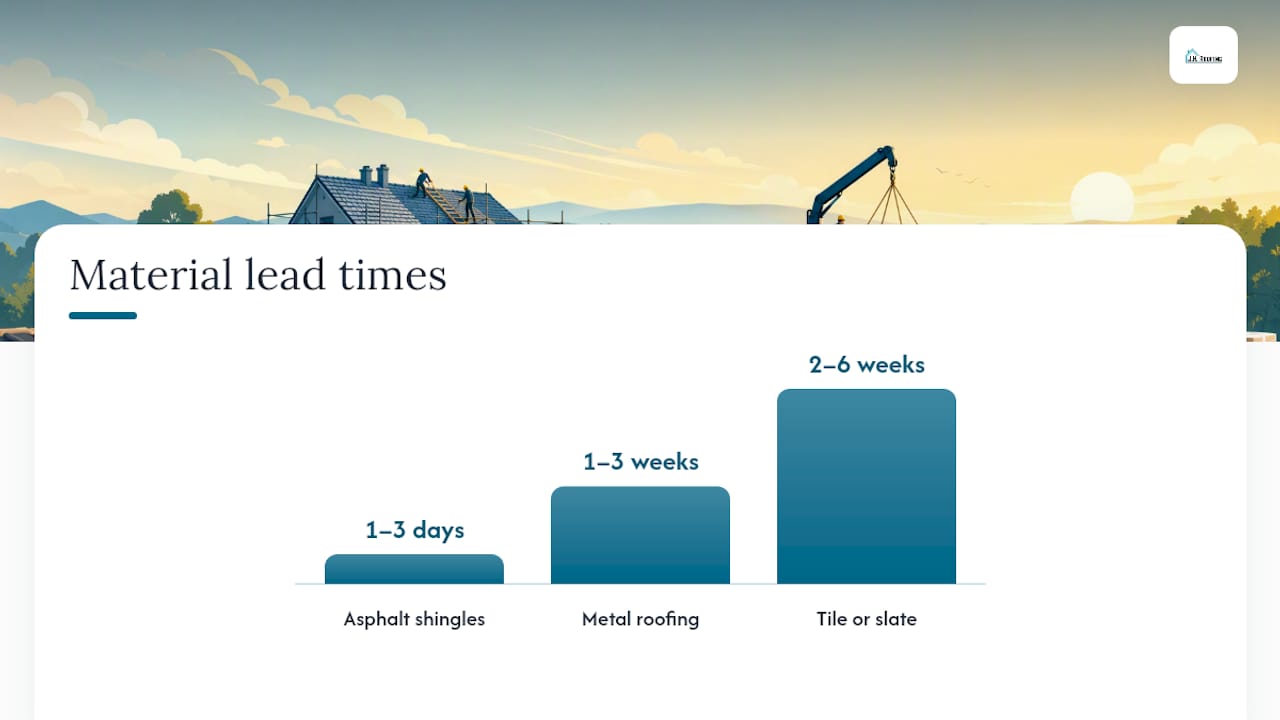

Diagram comparing roof material lead times

Crew scheduling. Backlogs after a storm or during peak season can push a start date out by weeks. Locking a date with a deposit early protects your slot.

Tear-off and deck repair. Multiple old layers or hidden rot can turn a one-day tear-off into two.

Quick math: a typical project runs roughly 3 weeks of pre-install waiting, 3 working days on the roof, and 2 business days for inspection, landing around 4 weeks total when crew scheduling is the bottleneck.

Final inspections, especially in jurisdictions requiring both a mid-install deck check and a final sign-off, can add a few more days while the crew waits for the inspector.

What Actually Determines How Long Your Roof Takes

Two roofs of identical square footage can take wildly different amounts of time, and it usually comes down to five variables you can partly control.

Weather is the top delay cause across the industry, ahead of deck damage, permit backlogs, and material shortages. Late autumn and early spring bring the highest risk of rained-out days.

Roof complexity matters more than most homeowners expect. Steep pitches above roughly 8:12 and roofs with multiple dormers or chimneys slow crews down because of added safety precautions and extra flashing work around every penetration.

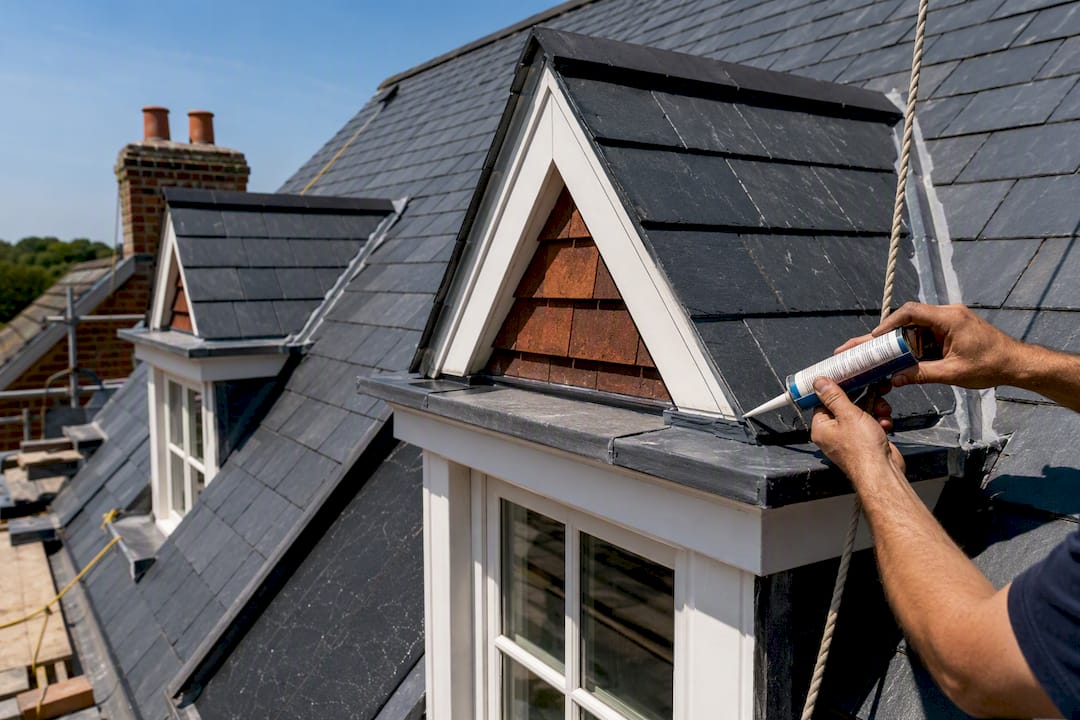

Hands applying flashing on complex steep roof dormer

Material choice changes install speed on its own. Asphalt shingles go fastest; tile and slate require slower, more careful handling per piece.

Hidden damage under old shingles is the wildcard every contractor budgets contingency time for.

Local permit rules and conservation area or historic-district restrictions can add review time you won't see coming if you don't ask early.

Ways to keep your schedule tight:

  • Choose widely stocked materials over special-order options when your roof allows it
  • Get a written delivery date from your contractor, not a vague "should be here soon"
  • Book during off-peak months (late winter, midsummer) if your schedule allows it

Pro Tip: Ask your contractor to confirm material delivery in writing before they schedule your crew. A confirmed delivery date is worth more than any verbal estimate.

A Day-by-Day Look at the Installation Itself

For a typical asphalt-shingle roof under 3,000 square feet, the actual on-roof work follows a predictable nine-stage sequence completed in one to three working days.

  1. Pre-day staging: materials, skip, and protective tarps are placed the day before or early morning
  2. Day 1: tear-off begins, old shingles and underlayment are removed, waste hauled to the skip, and the deck is inspected for rot the moment it's exposed
  3. Day 2: any deck repairs are closed up, then underlayment, flashing, and field shingles start going down
  4. Day 3: remaining shingles, ridge caps, and vents are finished, followed by full cleanup and a magnetic sweep for stray nails

A well-prepared, simple gable roof with no deck damage can sometimes wrap in a single long day if a skilled crew has every material staged beforehand. Rain or discovered rot converts what should be a partial day into a full extra workday, which is why smart contractors quote a range instead of a fixed date.

Getting Your Home Ready Before the Crew Arrives

A few minutes of prep the day before saves the crew hours and protects your property:

  • Move cars, garden furniture, and anything valuable away from ladder and skip access zones
  • Clear or cover loft storage, since debris and vibration can shift items during tear-off
  • Secure pets indoors away from open garage doors or gates
  • Confirm skip placement and delivery routes with your contractor ahead of time, and ask about scaffolding location and any noise windows for neighbors

After the Crew Leaves: Checks and Warranty

Before you consider the job done, walk the property with your contractor and check flashing, pipe boots, vents, and gutters, then ask them to inspect the attic from inside for daylight gaps.

  • Get a full handover pack: materials list, manufacturer warranty details, and workmanship warranty terms with a direct contact
  • Where your local authority requires a building inspection, confirm the timing since it affects final acceptance of the work
  • Ask how to log any snags and what response window to expect for follow-up repairs

Reviewing seasonal maintenance tips after your new roof goes on helps you catch small issues before they become warranty claims.

Why Real Experience Changes the Estimate

Jhroof is a family-owned roofing service with over 10 years working on homes across Ashford, Folkestone, Canterbury, and Maidstone, insured and backed by a 4.7-star Google rating. That includes new roof installations, flat roofing, and 24-hour emergency response when a timeline suddenly can't wait.

The Truth About Roof Replacement Timelines Nobody Tells You

Most guides treat the installation phase like it's the whole story. It isn't. The one to three days on your roof are almost never what stretches a project into two months. The bottleneck sits earlier, in permits, material lead times, and whoever's crew calendar you're waiting on.

That reframing matters because it changes what you should actually negotiate with a contractor. Don't just ask "how many days on the roof?" Ask what your material lead time looks like, whether they've confirmed delivery in writing, and how far out their crew calendar runs. A contractor who can answer those three questions specifically is telling you more about your real timeline than any generic quote.

What gets underrated is deck condition. Everyone budgets for weather delays. Fewer homeowners budget for the possibility that tear-off reveals rot nobody could see from the ground, and that single discovery is what turns a tidy three-day job into a week. Ask about contingency time before you sign, not after the tarps come off.

— Gabbi

Get a Free Roof Replacement Quote in Kent

Once you know your realistic timeline, the next step is getting a firm number from someone who won't pad the schedule to cover their own uncertainty. Jhroof provides free, no-obligation quotes across Ashford, Folkestone, Canterbury, and Maidstone, with the kind of responsive scheduling that comes from over a decade of local roofing work.

Jhroof

Whether you need a full re-roof, a flat roof replacement, or an emergency call-out after storm damage, Jhroof's team gives you a realistic start date instead of an optimistic one, backed by the material knowledge to tell you upfront if your chosen shingle or tile is going to add weeks to the wait. If your roof has multiple layers, dormers, or a steep pitch, that's exactly the kind of complexity worth discussing before you commit to a date.

Get your free roof replacement quote and find out exactly what your timeline looks like before you book anyone.

Sources
